Final Inspection Status Check

A final inspection status check asks whether the official record for one exact permit shows the inspection event that closes that permitted scope. Start with the issuing authority’s permit or inspection system and the full permit number. Use the address and parcel to confirm the property, not as a substitute for matching the permit.

An issued permit is not a final inspection. A passed rough or partial inspection is not the final result for the whole scope, and a final label does not certify present condition or workmanship. Copy the agency’s inspection type, result, and date exactly, then look for later corrections or reinspections.

Use the issuing authority’s inspection record

If the responsible office is unknown, the USA.gov local government directory can help locate candidate governments. Confirm the actual permit authority and its inspection-record instructions on the agency’s own site before interpreting a result.

Use both the address and parcel number

For the final-inspection check, have the street address, parcel number, owner or applicant name, permit number, and an approximate work date ready.

  • Exact street address
  • Parcel or assessor number
  • Permit or application number
  • Issuing city or county

Open the permit, inspection, and completion history

  1. Confirm the property, full permit number, work description, and issuing authority before reading inspection entries.
  2. Open the inspection history for that exact permit and identify the inspection type that would close the permitted scope; do not substitute an earlier rough inspection.
  3. Copy the agency’s result label and date exactly, then check for a later correction, reinspection, cancellation, or final event.
  4. Check related building and trade permits because electrical, plumbing, mechanical, fire, or occupancy closeout may be recorded separately.
  5. If the expected final entry is absent, check document and notice areas, the authority’s legacy system, and then request the named inspection record using the full permit number.

Read issued, finaled, expired, and open separately

To complete the final-inspection check, the result is strongest when the permit, inspection events, and final status refer to the same scope of work and property.

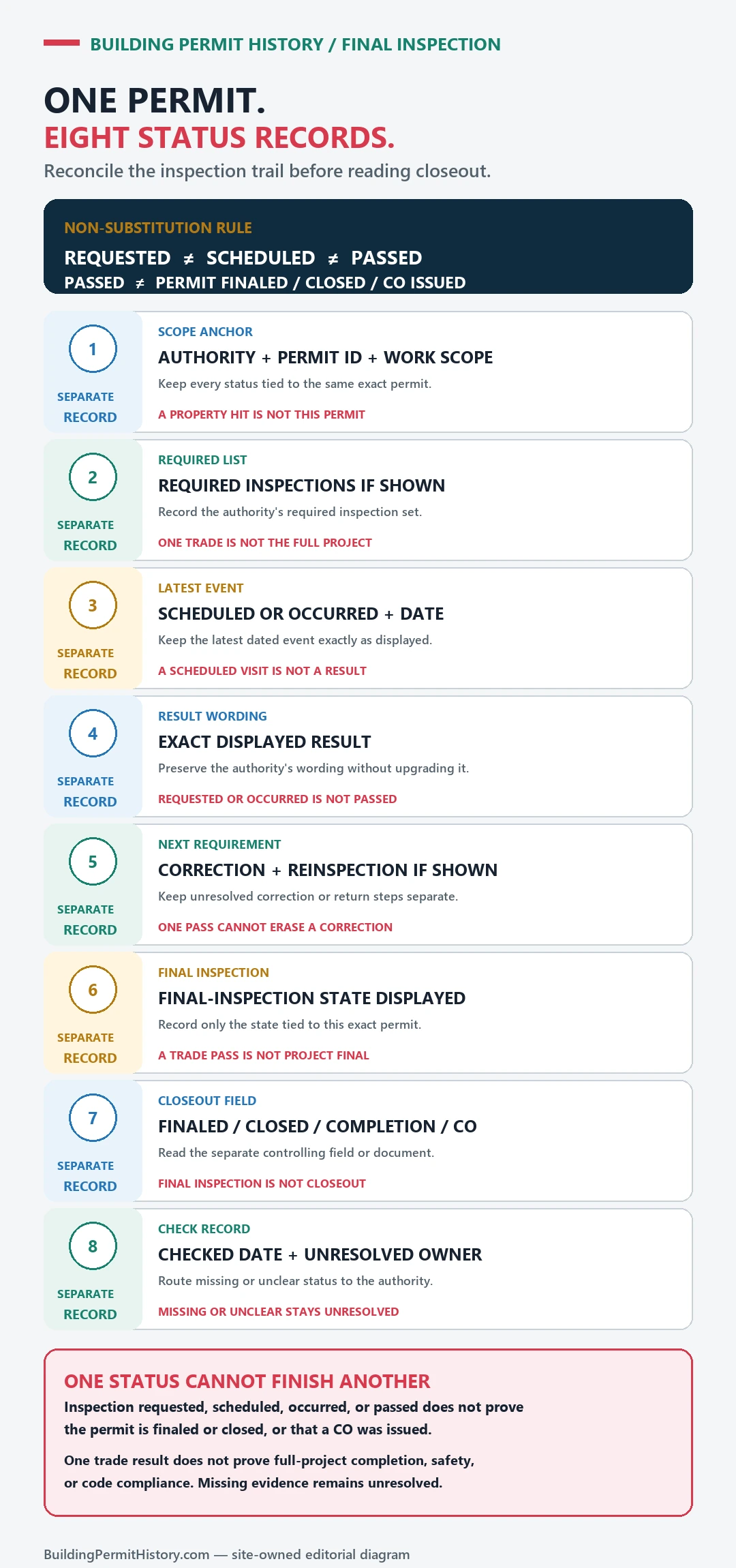

Eight-record final inspection status reconciliation separating required inspections, dated events, result wording, corrections, final inspection, permit closeout or CO, and unresolved ownership
For one exact permit, reconcile eight records: responsible authority, permit identifier, and work scope; the required inspection list if shown; latest scheduled or occurred event and date; exact result wording; any correction or reinspection requirement; final-inspection state; a separate permit closeout, finaled, closed, completion, or certificate-of-occupancy field; and checked date plus unresolved answer owner. Inspection requested, scheduled, occurred, or passed does not prove the permit is finaled or closed or that a CO was issued. One trade result does not prove full-project completion, safety, or code compliance. Source paths: the USA.gov local government directory and NYC DOB Building Applications and Permits; Building Permit History editorial diagram; article inspected July 27, 2026.
Evidence foundNarrow conclusion
Permit issuedThe authority recorded issuance; this is not a final inspection result.
Rough or partial inspection passedThat named stage passed; later required stages remain separate.
Final inspection resultCopy the exact type, result, and date, then check for later corrections or reinspections.
No inspection entryThe searched view is incomplete or empty; check documents, related permits, older systems, and the records route.

A permit entry found through final inspection status check is insufficient to establish whether the work passed final inspection, matches the building today, or complied with rules owned by another department.

Permit issued, but no inspections appear: check the missing record layer

An issued permit with an empty inspection view is insufficient to establish whether an inspection occurred, failed, or was omitted. First confirm that you opened the issued permit rather than the application, then check related building and trade permits, document tabs, inspection notices, legacy systems, and the official records-request route. Carry the full permit number through every step.

Inspection information is organized differently across official systems. San Jose’s Help for SJPermits & SJePlans page links to the Find Inspection Records guide, which tells users to select the property, open “View Permit/File,” choose the correct permit, open Details, and then check Document for inspection notices. An inspection can therefore exist as a document even when a searcher expects a simple inspection-results table.

Seattle SDCI’s Research a Project page routes readers among property, project, permit, inspection, document, and historical sources. Houston’s official Permits and Inspections overview similarly separates permit search, plan status, inspection history, and the limited Sold Permit Search. These examples show why one empty screen is not a complete records search.

Use the symptom to choose the next official check

What you seePossible record-layer explanationNext official checkWhat you cannot conclude
Permit says issued; inspection area is emptyInspection notice may be a document, a separate module, or not yet postedOpen permit details and documents; use the authority’s inspection instructionsNo inspection ever occurred
Building permit is visible; electrical, plumbing, or mechanical inspections are absentTrade inspections may belong to separate child permitsFind related trade permit numbers and inspect each historyBuilding final covers every trade
Current portal finds the permit but not old eventsHistorical inspections may be in a legacy system or archiveUse the official old-record or records-request routeThe work had no inspection
Address result shows several similar permitsThe wrong application, revision, or permit may be openMatch full number, scope, dates, and parent/child relationshipsThe nearest record belongs to the project
One approved inspection appears, but no finalMore stages may be required or closeout may use another recordRead the issued permit, required inspection list, and final/occupancy routeThe project is complete
Portal is unavailable or the result is delayedTemporary outage, processing lag, or access restrictionRecord the error and contact the official unit with the permit numberThe underlying record does not exist

The explanations are possibilities, not findings. Use the issuing authority’s response to determine which one applies.

Confirm the property, permit, and scope again

Start with the legal address and parcel. Then compare the full permit number, permit type, work description, issue date, applicant or contractor where relevant, and related project number. An application and an issued permit can share a project context while carrying different records. A revision can also create a later version whose inspections are attached elsewhere.

If the portal found the address but not the expected permit, try the stable identifiers described in the Permit Number Lookup Guide. If the property itself is not found, use Address Not Found in a Permit System before declaring a records gap.

Read the scope carefully. A general building permit may not contain inspections for separately permitted electrical, plumbing, mechanical, fire, elevator, solar, or utility work. The guide to Plumbing, Electrical, and Mechanical Permit Records explains how to assemble that permit family.

Look in document and notice areas

Do not stop at a status summary. Open every official section available for the correct permit: inspections, documents, attachments, notices, related records, revisions, conditions, and correspondence. Save the exact document title, date, permit number, inspection type, and result.

An “inspection notice” can contain a result or correction that is not summarized elsewhere. A final approval can also appear under an occupancy, completion, or related parent record. Use the agency’s terminology instead of rewriting any favorable result as “fully approved.”

If the site exposes private or sensitive information, do not republish it. The research goal is the project evidence chain, not a personal-information file.

Search older systems and request the named record

When the permit predates the public portal’s stated coverage, follow the authority’s official historical instructions. Prepare the current and former address, parcel, full permit number, approximate inspection date, inspection discipline, contractor or applicant when relevant, and the exact document needed.

A targeted request might ask for “the inspection history and final inspection record for permit [full official number]” rather than every record for the property. If the agency reports that no responsive record was located, preserve that wording and the search scope. It does not establish that no inspection occurred; it only records that the described search did not locate a responsive record.

The broader Building Permit Data Limitations guide explains retention, migration, and field-coverage gaps.

Keep an absent record separate from a failed inspection

This diagnostic ends when an inspection result is located or the official records route is exhausted and the remaining gap is documented. If the result says failed, rejected, partial, corrections required, or another nonfinal outcome, the question changes. The next task is to connect the objection or correction, responsible permit, corrective work, reinspection, and later result.

Do not use an absent-entry explanation to minimize a documented failure. Do not treat a failed result as evidence that every later inspection also failed. Those are separate records problems and should remain separate in the article structure.

State the narrow conclusion

After the search, report only what the evidence supports:

  • which official systems and record areas were checked;
  • the property and permit identifiers used;
  • which inspection or final records were located;
  • which related permits were checked;
  • what the authority said about an unavailable record;
  • what remains unknown.

An issued permit does not prove work began. An inspection approval does not prove the entire project reached final. A final result does not warrant present condition or workmanship. An empty portal view does not prove the opposite of any of those statements.

The reliable approach is to find the correct record layer, preserve the complete identifiers, and stop the conclusion where the official evidence stops.

If the permit history is incomplete

For an unresolved final inspection, provide the issuing office with the property, full permit number, work year, inspection discipline or type, approximate inspection date, and the exact portal sections or older systems already checked. Ask for the inspection history and final inspection record for that permit.
